Home Articles Routine Purging and Sealing
Preventive Maintenance

Routine Purging and Sealing: Preventive-maintenance strategy Cutting injection scrap

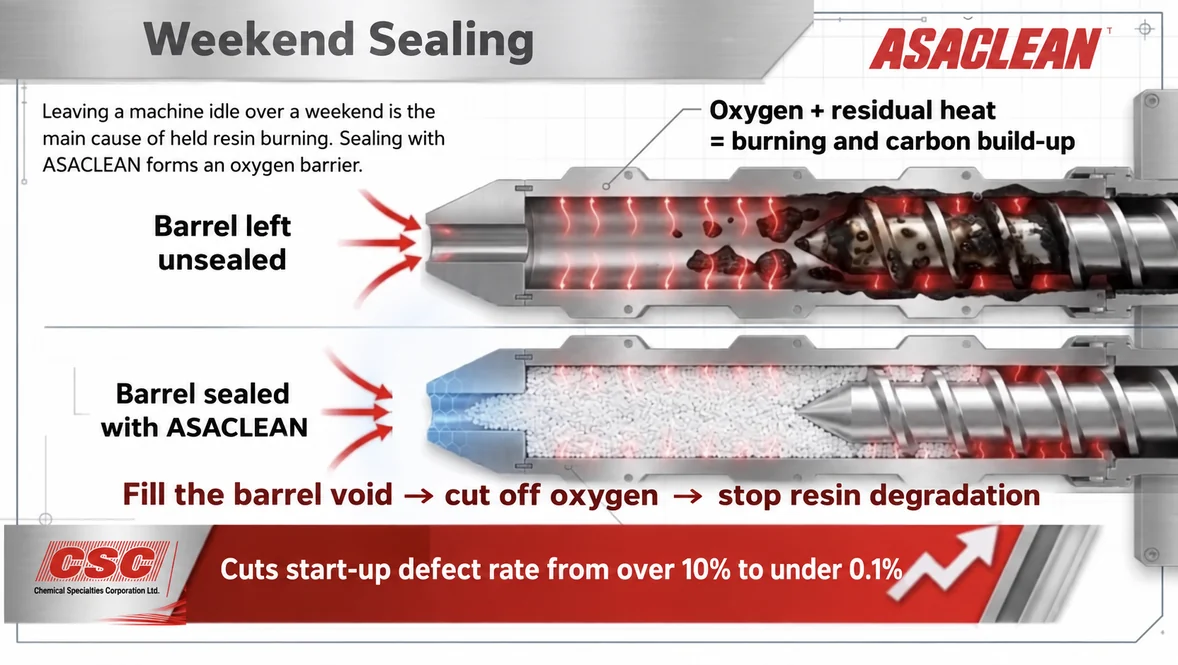

Preventive cleaning and Weekend Sealing with ASACLEAN
Barrels with and without ASACLEAN sealing compared

Why do leading Japanese and German plants never wait for Black Specks before purging? This article summarizes Proactive Maintenance thinking and repeatable-shift Routine Purging plus Sealing program design

Updated 15 June 2026 10-min read ASACLEAN Thailand technical team

1From Reactive to Proactive Maintenance

Reactive cleaning Waits for visible trouble such as Black Specks, color streaks or high rejects before purging. It risks:

In contrast Proactive Maintenance with Purging Compound Purges lightly and steadily, never letting residue build. Like daily toothbrushing instead of waiting for cavities.

Maker case evidence Asahi Kasei reports a customer running Regular Cleaning with Sealing cutting post-holiday defects from 3% to 0.3% And another cutting defects from 10% to below 1% These are single cases, not guaranteed values for every plant

2What Routine Purging means

Routine Purging Runs small preventive-table ASACLEAN doses, sweeping residue just Starting to form Before it hardens to carbon. Use in these situations:

3Sealing: protecting screws during stops

Sealing Holds ASACLEAN in the screw barrel instead of resin across long stops (8-hr overnight, 48-hr weekend, long holidays) to:

Technique Pick grades tolerating the production resin temperature, Non-GF maker-listed where Hot Runner exists, such as RU / RE / SL / PF

4Reading Asahi Kasei graphs and case results

Maker graphs never mean defects fall on identical lines at every plant. They show Scheduled cleaning pressing scrap rates low And pre-stop sealing cutting defects that typically climb after holidays or shutdowns

Asahi Kasei case-study graph showing defect-rate trends falling with ASACLEAN Regular Cleaning and Sealing
From Asahi Kasei case-study data: Yellow bands show cleaning cycles, post-program data runs lower, and sealing controls post-stop defects. Read as case-study trends, not every-line predictions.

Reported trial structure

Regular Cleaning + Sealing

3% → 0.3%

Xyron and m-PPE cleaned every 2 weeks with newEX and newUP, holiday sealing with newUP

Regular Cleaning

10% → <1%

ABS and black to PP and black changeover with scheduled UP-grade cleaning

Key limits: The maker published page lacks full details such as machine size, shot size, temperature, purge amounts, tracking duration and sample counts. Never set percentages as guaranteed results. Run controlled trials on real machines with baselines before switching methods.

Why sealing cuts post-startup trouble

Asahi Kasei explains held resin still meets residual heat and oxygen after stops, enabling thermal degradation and oxidation. Holding ASACLEAN in the machine cuts oxygen contact and residual-heat degradation. Startup purging then carries possibly degraded material out before part production.

ABS samples discoloring from oxidative degradation at 240°C after 0, 15, 30 and 60 minutes
Oxidative degradation of ABS at 240°C: Maker image shows ABS shifting transparent to yellow, brown and darker with heat-air exposure time. It explains held-resin risk mechanisms, not the graph defect rates above.

5Designing cleaning cycles from real data

Tables below are Trial starting points Not fixed standards. Tune to resin type, defect history, stop duration and the picked ASACLEAN grade terms.

Production patternRoutine Purging startConsider sealing when
Running 24/7 Single colorStart from PM cycles or before defect-graph uptrends, then tune to dataBefore risky resin-degrading PM or shutdown stops
Frequent color and material changeTie to high-contamination changeovers, split data by resin and color pairBefore holidays or long stops after procedural cleaning
Running 1–2 shiftsTrial pre-shift-end or weekly, comparing startup scrapWhen data confirms overnight holds oxidize or contaminate

6Amount and step principles

Cite the grade manual Amounts, temperatures, Back Pressure and screw positions differ by ASACLEAN grade, resin, machine and Hot Runner. Text below is concept-level workflow, never replacing the Technical Data Sheet or technician advice.

Routine Purging (short steps)

  1. Run the barrel near empty of resin
  2. Feed ASACLEAN per grade-manual or technician starting amounts
  3. Set temperature and Back Pressure per grade terms until discharge passes gates
  4. Feed new resin to rinse out

Sealing (in-machine hold)

  1. Confirm the picked grade fits machine resin, temperature and flow path
  2. Clean and fill ASACLEAN across zones per grade steps before shutdown
  3. Stop the machine and set screw position per grade and machine manual
  4. At restart set temperature and purge material out per steps before approving first parts

7Measurement: KPIs to track

Want a Routine Purging Plan table for your plant?

CSC technicians design PM programs by machine count, resin type and production shifts

85 common mistakes

  1. Using only at color or material changes

    Most plants reach for compound only on trouble. Yet Routine Purging belongs in preventive plans even with no color or resin change.

  2. Over-cutting amounts to save cost

    Too little compound purges incompletely. Leftover residue keeps building until real scrap and downtime costs dwarf hoped savings.

  3. Wrong grade for the job

    Each grade targets different purposes. Wrong picks cut purge effectiveness and may damage equipment long-term.

    Examples:

    • Glass-fiber grades through Hot Runner risk gate and fine-path wear
    • Glass-fiber grades sealing (screw-soaking) long risk cumulative friction harming screw and barrel surfaces
  4. Skipping post-purge rinse

    Unrinsed compound may contaminate first-lot parts into scrap or failed standards

  5. No data or result tracking (KPI)

    Without logged color-change times, scrap amounts or falling speck rates, no data supports value assessment or directional purging-program improvement

9FAQ

Small plant, few machines. Is Routine worth it?

Judge from plant scrap costs, color-change times, problem frequency and per-round purge costs. Trial Calculate ROI ROI with real figures before fixing permanent cycles

Need dedicated staff?

Trained operators with machine SOPs can run Routine Purging. CSC technicians can review grades, steps and acceptance checkpoints before real use.

One grade for every machine?

Sometimes, such as whole plant on similar-temp PP and PE. With engineering-plastics machines (Nylon, PC, PEEK) split grades. Ask technicians to optimize.

Can Routine Purging and Sealing share a grade?

Some grades serve both, but verify that grade manual. With Hot Runner consider maker-listed grades such as RU / RE / SL / PF Per real resin and temperature

Can the 3%-to-0.3% result target my plant?

Use it as strategy-potential evidence, never as a guarantee. That case ran Xyron and m-PPE, newEX and newUP and specific cleaning cycles. Set targets from real-machine baselines and controlled trials.
